Create and edit activity
An activity is one piece of work on the day. It says what was done (type and task), where it was done (unit), and who did it, with which equipment and for how long. To create one, click Add activity on Details tab. To change an activity, click the pencil on its row. The same dialog opens, titled Edit Activity. Activities can also be created from Time-it time logs. See Time-it.

1. What you fill in for an activity
-

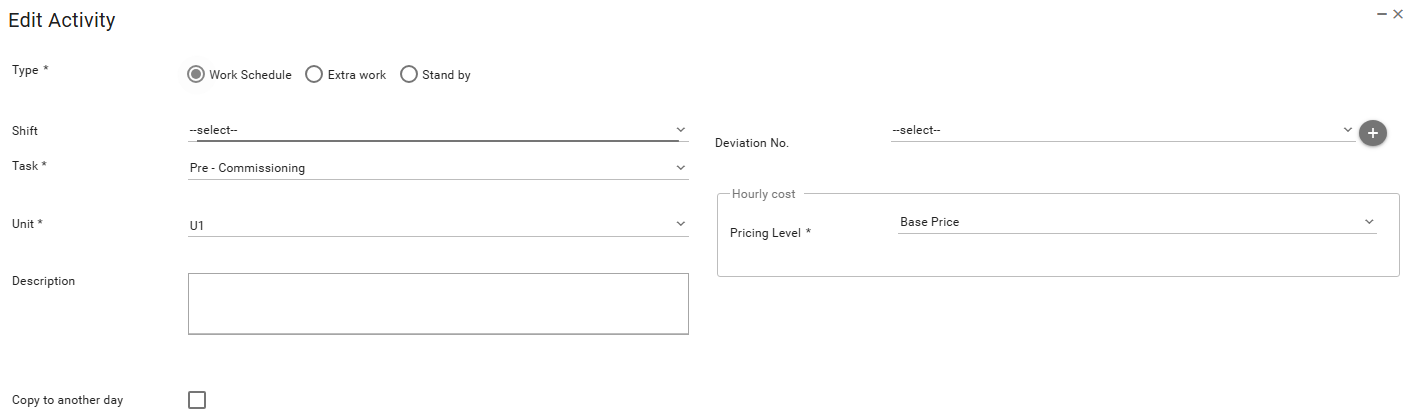

Type (required). The type says what kind of time you are recording: planned work, unplanned extra work, or waiting. It also decides whether you must link a deviation, whether you see the task's progress, and which pricing level is filled in for you. A new activity starts as Work Schedule. When you create it from Time-it time logs, it takes the type of those logs.
- Work Schedule is the planned work, the job the crew is on site to do. Choose it for everyday work from the plan. For example, the riggers and the main crane lift the nacelle onto the tower as planned, or the technicians commission a turbine. A deviation is optional here. On the Timeline, its bars are green.
- Extra work is useful work that was not planned and had to be done because something unexpected happened. Choose it when the crew works, but on something nobody planned. For example, the blades arrive dirty and must be cleaned before the lift, or the paint on the nacelle was damaged in transport and needs touching up. No access to a turbine can also cause extra work. You must link extra work to the deviation that caused it. On the Timeline, its bars are orange.
- Stand by is time when people or equipment are on site and ready, but cannot work. Choose it for waiting time. For example, the wind is too strong to lift, so the crane and the riggers wait. Or the crane is broken, or the nacelle delivery is late. You must link standby to the deviation that caused it. On the Timeline, its bars are red.
-
Task (required). Pick the task from the list. Tasks are grouped under their construction stage. When you create an activity, you can tick more than one task.
-
Unit. This field appears only after you choose a task that is done on units, such as a turbine. It is then required. When you create an activity, you can tick more than one unit. If you choose a non-unit task, you do not see the Unit field, because there is no unit to pick.
-
Shift. Optional. You see this field only if your project uses shifts.
-
Description. Optional free text.
-
Deviation No. A deviation is an unexpected event that is recorded in the project with a number, for example bad weather or no access. Use this field to link the activity to the deviation that caused it. It is required for Extra work and Stand by. For Work Schedule it is optional, and the list shows only the deviations marked Work schedule enabled. If the deviation you need is missing, the project owner can add it with the plus button next to the field. See Deviation numbers.
-
Pricing Level (required), under Hourly cost. This decides which price applies to the hours. The choices are the pricing levels set up for the project. A pricing level can be set as the default for one type. When you choose a type, the app fills in that default for you. If no pricing level is the default for that type, the field is empty and you choose one yourself.
-
Lump sum. A lump sum is a fixed price agreed for finishing a piece of work, whatever the hours, for example a fixed amount for installing a whole turbine. This part of the dialog appears only when a lump sum is set up for exactly what you are recording. The lump sum must be for the organization role of this report, for the chosen task, and for the chosen unit. Lump sums exist only for Work Schedule, so you never see this part on Extra work or Stand by. If you tick several units, it appears only for a lump sum that covers all of them together. See Lump sum prices.
- Price variant (required) says which part of the lump sum this work belongs to, for example the full turbine or the turbine without blades. The list shows the lump sum name and the variant name. When there is only one variant, it is chosen for you.
- Price subvariant and Execution option (required when you see them) appear only when the variant has more than one, for example a different price for each crane, or for a partly or fully derigged crane. When the subvariant names a resource, the dialog reminds you to add it to the activity.
- When your tasks and units fall under different variants, you see a table instead, with one row per task and unit. Choose a variant for each row.
- A green tick means the lump sum payment has already been released. You can then no longer change the variant.
- Include hourly cost is unticked by default. The hours are still recorded, but their hourly cost is not counted, because the lump sum pays for this work. Tick it when the hours should be paid as well, on top of the lump sum, at the pricing level you chose. For example, the installation is paid as a lump sum, but the client agreed to pay the crane hours too. On the Details tab the pricing column then shows L.S. + and the pricing level instead of L.S.
- If a released lump sum payment depends on this activity alone, you cannot delete the activity or move it to another task, unit, or type. The app tells you which payment it is. Reverse that release on Lump Sum Payments first.
Here the task Nacelle on unit U1 falls under the lump sum for the main installation. The app has picked the full turbine as the variant, the main crane as the subvariant, and its first execution option. Include hourly cost is unticked, so only the lump sum pays for this work.
For some tasks the dialog also shows the task's progress. You see it for Work Schedule and Extra work, not for Stand by. When you save without updating the progress, the app may ask you to confirm.
Tick Copy to another day to copy this activity to other days when you save it. You then choose the days to copy to. The rules are the same as for copying on the report. See Daily report.
Click Save to store the activity. Cancel closes the dialog without saving.
2. People and equipment

In the lower part of the dialog you record the people and equipment that worked on the activity, and their times.

On the left you see what you can add. On the right, Resources in activity shows who and what is already on the activity. On a new activity this table starts empty (No records).
- Resources lists the people and equipment in the project together under Available resources. TP shows whether a row is a person or equipment. Use the two icon buttons at the top left to open Manage users and persons in project or Manage equipment in project when someone is missing.
- Groups lists the saved groups of your organization role, for example Crane, under Available Groups, with the number of people and equipment in each that are not on the activity yet. Click the arrow at the start of a row to see who is in the group. When everyone in a group is already on the activity, the group is hidden. Manage Groups opens the same form as Planning > Resources Groups, so you can create or change a group without leaving the report. You see this button only if you may edit resource groups.

A group saves you from picking the same crew one by one every day. Here, one tick adds three riggers and their assisting crane.
To add people and equipment:
- Tick the rows you want on Resources or Groups.
- Click the arrow icon Add selected resources to activity. The double arrow, Add all resources to activity, takes every row. For a group, this adds everyone in the group who is not on the activity yet.
- In the Add resources to activity dialog, enter the start and end time. If a person has no role in the project yet, choose a person role.
- Click Save. The rows appear under Resources in activity with From, To, and Total. For equipment, set how many pieces worked in the Qty column. The Subtotal shows the hours of people and of equipment.
To change times, edit From and To in a row. You can also tick several rows and click Edit selected. To remove one row, open its menu (three dots) and choose Remove resource from activity. The bin in the header, Remove all resources from activity, removes everyone.
Time already logged in Time-it
Time-it is a separate app where people log their own working time. The Synchronization between SUM-IT and Time-it box compares the hours on this activity with the time people logged in Time-it. You see this box only when your organization has switched on Time-it, and only on your own organization's report. These are the same conditions as for the Time-it tab. See Time-it.
- Show difference displays the difference between the time registered in Time-it and the activity time recorded in the daily report.
- Automatically sync activity times to Time-it time logs copies time from activities to the matching Time-it time logs that are not yet approved.
- Copy time from Time-it time logs to related activities copies the logged time into this activity.
Who may change whose activities is described under Permissions in Daily reports.
